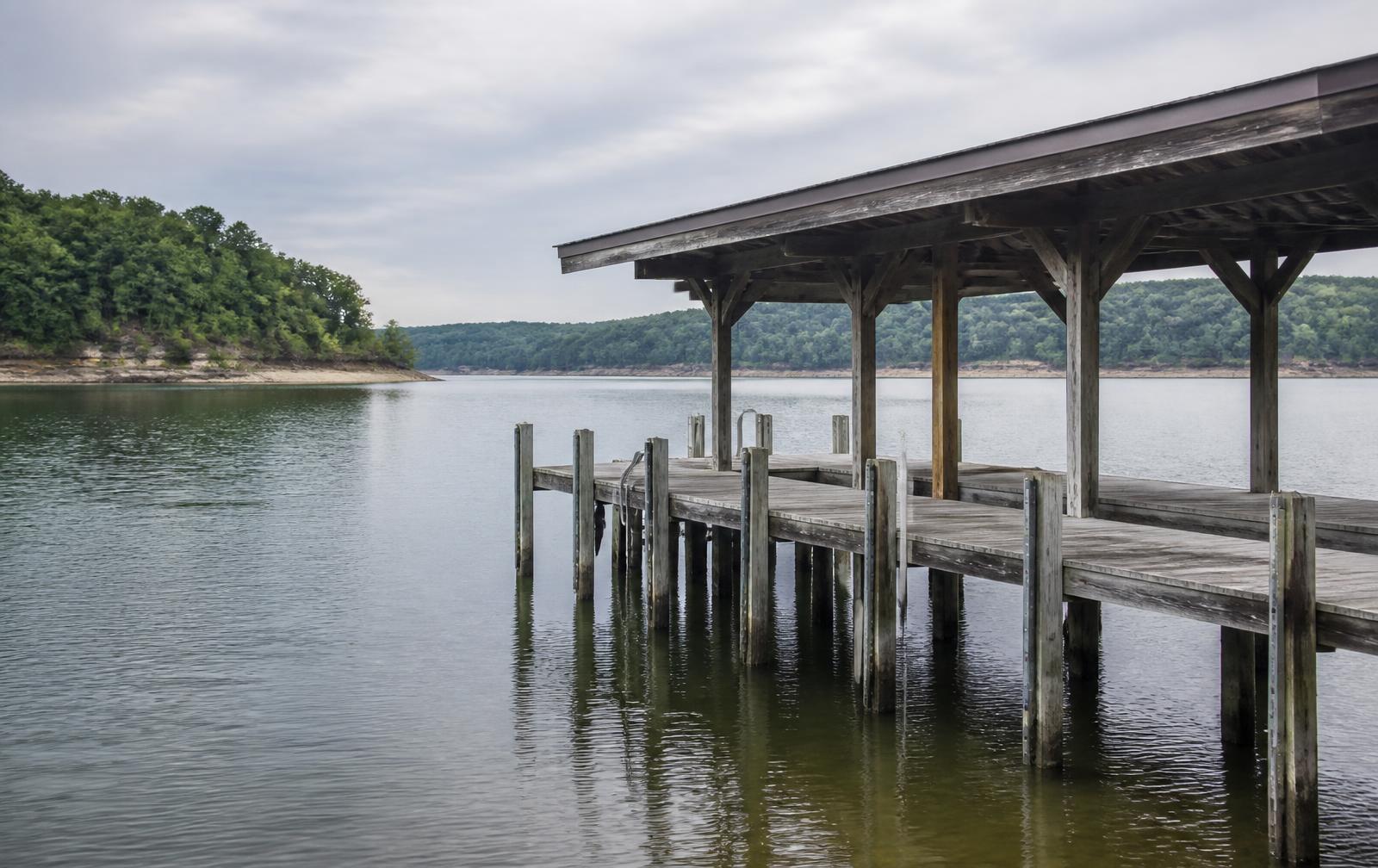

Wooden dock and covered boathouse on Lake Guntersville, Alabama, with the waterline band visible on the pilings

Lake Guntersville · Marshall & Jackson Counties

Dock, Boathouse & Boat Lift Builders on Lake Guntersville

This lake only moves about two feet a year. That changes everything about how a dock ages here — and where it fails first.

  • Free, no-obligation dock look
  • Upfront pricing before work starts
  • TVA 26a permit paperwork handled
  • Barge work year round

Tell us what's going on with my dock

Four questions. We call you back — no forms to chase, no price guessed sight unseen.

Start where you are

593 to 595 feet

Why docks on this lake rot in a stripe

TVA holds Lake Guntersville at a minimum winter elevation of 593 feet and a typical summer operating range of 594 to 595 feet. The lake is drawn down starting after Labor Day and comes back up in late April or early May.

That is about a two-foot swing across a whole year. On a tributary lake the water drops ten or twenty feet and the wet/dry line sweeps up and down the piling. Here it barely moves.

So the damage concentrates. Every cycle of wetting and drying hits the same narrow band of timber, year after year. On most docks we look at, the wood a foot above and a foot below the summer waterline is measurably softer than the wood two feet higher — even when the deck above looks sound. It is the single most predictable failure pattern on this lake, and it is why probing a piling at the waterline tells you more than any amount of walking on the deck.

The same two feet is why there is no real off-season here. The lake never drops far enough to strand a dock or give you a dry platform to work from. Only the shallowest margins go dry at winter pool. Everything else is barge and waders work, in January the same as in July.

Four stages, and what each one costs

Most docks we see fall into one of four states. Finding yours narrows the conversation fast.

  1. 01

    Sound

    No soft spots when probed, hardware tight, no visible lean.

    The work: Cleaning, sealing, hardware checks.

    Range: $100–$300 pressure washing, $150–$600 sealing, $50–$200 for an inspection. (HomeGuide)

  2. 02

    Soft

    Decking gives underfoot, boards cup or split, nail pops, surface rot at the waterline band. Structure still good.

    The work: Re-deck, replace fasteners.

    Range: $30–$55 per square foot installed. (HomeGuide)

  3. 03

    Structural

    Pilings soft when probed, hourglass narrowing at the waterline, visible lean, movement beyond normal bounce, hardware pulling out of wood.

    The work: Piling replacement, framing repair.

    Range: $500–$1,500 per piling replaced; $4,000–$6,000 for a typical 4–6 piling job. (Angi)

  4. 04

    Gone

    Storm damage, dock broke loose, foundation failure, or repair cost approaching replacement cost.

    The work: Rebuild.

    Range: $1,000–$33,000 for storm damage depending on scope; full replacement averages around $15,000. (HomeGuide, Angi)

Rule of thumb: when repair passes about half of replacement cost, rebuild. These are market ranges for this kind of work, not a quote — where a specific dock lands depends on water depth, access and how far the rot has moved past the band.

Full cost breakdown for this lake, including boathouses and lifts →

Plan around the permit, not the weather

Every dock, pier, boathouse, boat lift, walkway and shoreline alteration on this lake needs TVA approval under Section 26a of the TVA Act. That includes modifications to a dock that is already there.

TVA's application fee for minor shoreline alterations — which covers residential docks, piers and boathouses — is $1,000. TVA states it strives to issue permits for minor construction within 100 days, and that timeframes can extend to 120 days.

Because the lake gives you no seasonal work window, that permit timeline is what actually sets your schedule. Apply in the fall and you have a dock for spring. Apply in April and you are looking at late summer.

One trap worth knowing about: if you have just bought a lakefront property, TVA requires a new application within 60 days of purchase — even when the dock is already built and was permitted for the previous owner. Permits do not transfer with the deed.
